Canva Enterprise Implementation
Project Management, Policy Formation & Documentation, User Management, Account Structure & Workflow Development
Brief
As Thompson Thrift's portfolio of luxury apartment communities continued to grow, Canva had become the primary platform for creating onsite marketing materials. Without standardized processes or centralized brand management, content creation varied widely across communities, making it difficult to maintain consistency, manage accounts, and ensure teams had access to approved assets. The project focused on implementing an enterprise-wide system that improved efficiency while strengthening brand governance across more than 40 communities.
The solution extended well beyond a software rollout. A scalable framework was developed in collaboration with Marketing, IT, and Canva's implementation team, introducing dedicated brand kits for every community, standardized templates, approval workflows, user training, and account governance. Centralized workspaces gave onsite teams immediate access to approved logos, photography, fonts, and design assets, while review processes provided greater visibility into brand usage and opportunities to expand the template library.
The implementation transformed Canva from a collection of disconnected accounts into a centralized content creation platform. Teams gained the tools to produce branded materials more efficiently, Marketing established stronger oversight of brand application, and the organization adopted a scalable system that supports continued growth while maintaining consistency across the portfolio.
Deliverables
-

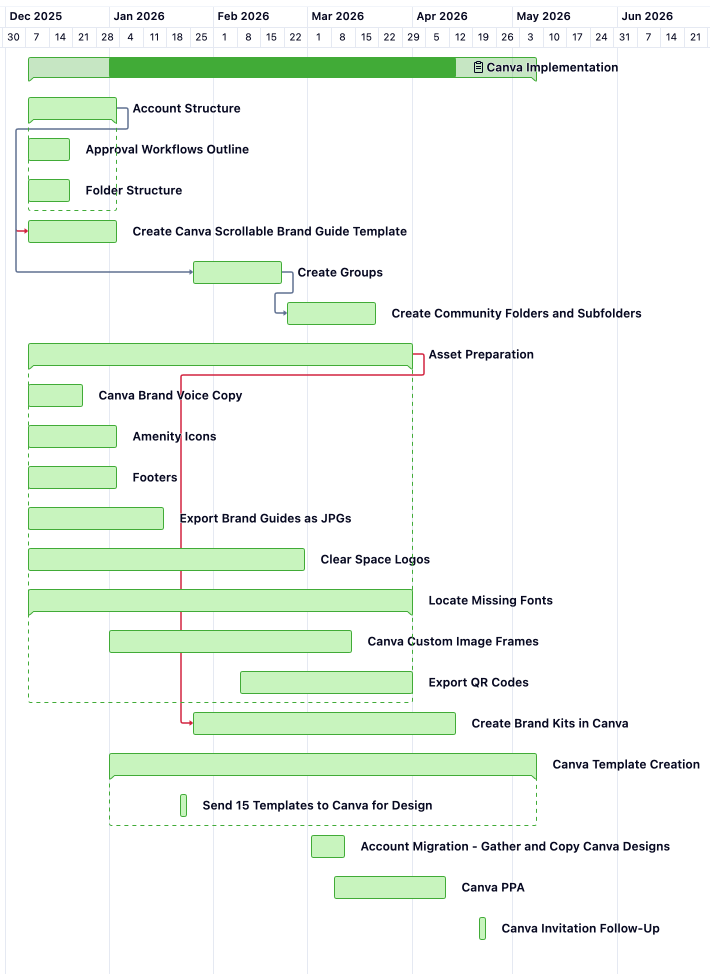

Wrike Roadmap
Account Structure
Folder Structure
Approval Workflows
Brand Kit Structure
User List
User On-Boarding Policy
-
1,000+ Photos
550+ Logos
75+ Patterns
75+ Font Files
50+ Iconography Sets
50+ Templates
25+ Borders/ Dividers
25+ Image Frames
-
47 Brand Kits
Asset Categories & Sections
Process Creation & Documentation
Team Training
Quality Check
-
Canva Account Migration Communication
Launch/On-Boarding Communication
Training Session Leadership
Technical Support
47 Brand Kits
Created upon launch of Canva Enterprise
The first month following Canva Enterprise implementation demonstrated strong early adoption among users.
Meaningful progress was made toward the initiative’s core objectives of brand governance, self-service content creation, operational efficiency, and account security.
242 Designs
Created in the first month after launching Canva Enterprise
356 Designs
Published in the first month after launching Canva Enterprise
94 Users
Licensed upon launch of Canva Enterprise
66 Designs
Approved in the first month after launching Canva Enterprise
